Costs
Part of A Planning Order for Multifamily EV Charging
How boards review multifamily EV charging bids
A multifamily EV charging cost review aligns scope, site assumptions, operating bills, incentives, and outcome measures before board approval.
Step 1: Give every proposal the same boundary
A condominium board receives three proposals for a multifamily EV charging project, yet the totals cover different work. It must decide what each price buys rather than treat the smallest figure as the winner. The steps below show how the board can align assumptions and assess outcomes before approval.
For every offer, the board separates equipment, construction, utility work, and operations, then asks bidders to give one written answer for each line. Equipment means units, pedestals, cable management, signs, and spare parts; construction includes trenching and pavement restoration; utility scope identifies upgrades or meters; operations lists recurring charges and their pricing basis.
Four Budget Lines Compared
Budget line
- Equipment
- Units, pedestals, cable, bollards
- Construction
- Design, permits, panels, conduit, trenching
- Utility work
- Service upgrade, transformer, new meter
- Operations
- Electricity, demand charges, network fees
What sits in it
- Equipment
- Port count, networked, outdoor rating
- Construction
- Distance from panel, digging, inspector
- Utility work
- Spare feeder capacity on your street
- Operations
- Session volume and rate structure
What moves it
- Equipment
- Construction
- Utility work
- Operations
| Line | Question for each bidder |
|---|---|
| Equipment | Which units, pedestals, cable management, signs, and spare parts are included? |
| Construction | Does the price assume trenching, and who restores the pavement? |
| Utility work | Is a service upgrade, transformer, or new meter included, or ruled out? |
| Operations | Which charges recur, and do they scale with ports, users, or transactions? |
With replies aligned, the board can compare specifications instead of treating unlike totals as a contest. It uses a multifamily specs comparison to score the written answers, while keeping construction and utility assumptions visible beside each price.
Step 2: Check what the site could change
The next check is whether each proposal fits the property: equipment prices are easier to anticipate than construction costs, which depend on site conditions and commonly overrun.
The board tests each estimate against rough ranges, then identifies the physical conditions that could change the work before accepting a number as credible.
In September 2026, a commercial Level 2 station cost $3,000 to $12,000, a dual-port unit cost $6,000 to $20,000, and installation alone cost $400 to $1,800 when spare capacity was already nearby. The board uses these figures as reference points, not as a substitute for site-specific pricing.
September 2026 Cost Benchmarks
- $3,000–$12,000Commercial Level 2 station
- $6,000–$20,000Dual-port unit
- $400–$1,800Installation with spare capacity nearby
Construction remains the less predictable part of the estimate. The utility answer is also decisive: either spare feeder capacity exists on the street or it does not. The difference can mean a weekend of conduit work or a year of coordination, so the board asks each bidder to explain its assumptions rather than leave the issue unresolved.
The electrical team prices likely estimate changers, including trenching and pavement restoration, against the same list for every proposal:
- A service, transformer, panel, or switchgear upgrade
- Long conduit runs, or routes through finished space
- An electrical room with no physical room left
- Separate metering or billing hardware
- Communications cabling to the parking area
- Accessible parking changes and the route back to the door
After checking those items, the board asks bidders to price the conditions they have found or state clearly what remains excluded. This makes a long conduit route, an unavailable panel location, or an upgrade assumption visible before approval, rather than an unexpected addition after construction begins.
Step 3: Put omitted preparation on the ledger
The board adds design, approval, and legal work to the project budget even when early proposals leave those items out.
Its ledger lists engineering where needed, site plans, permit fees, utility studies, legal review, inspections, project management, and resident communications as separate costs, rather than allowing a low construction total to hide them.

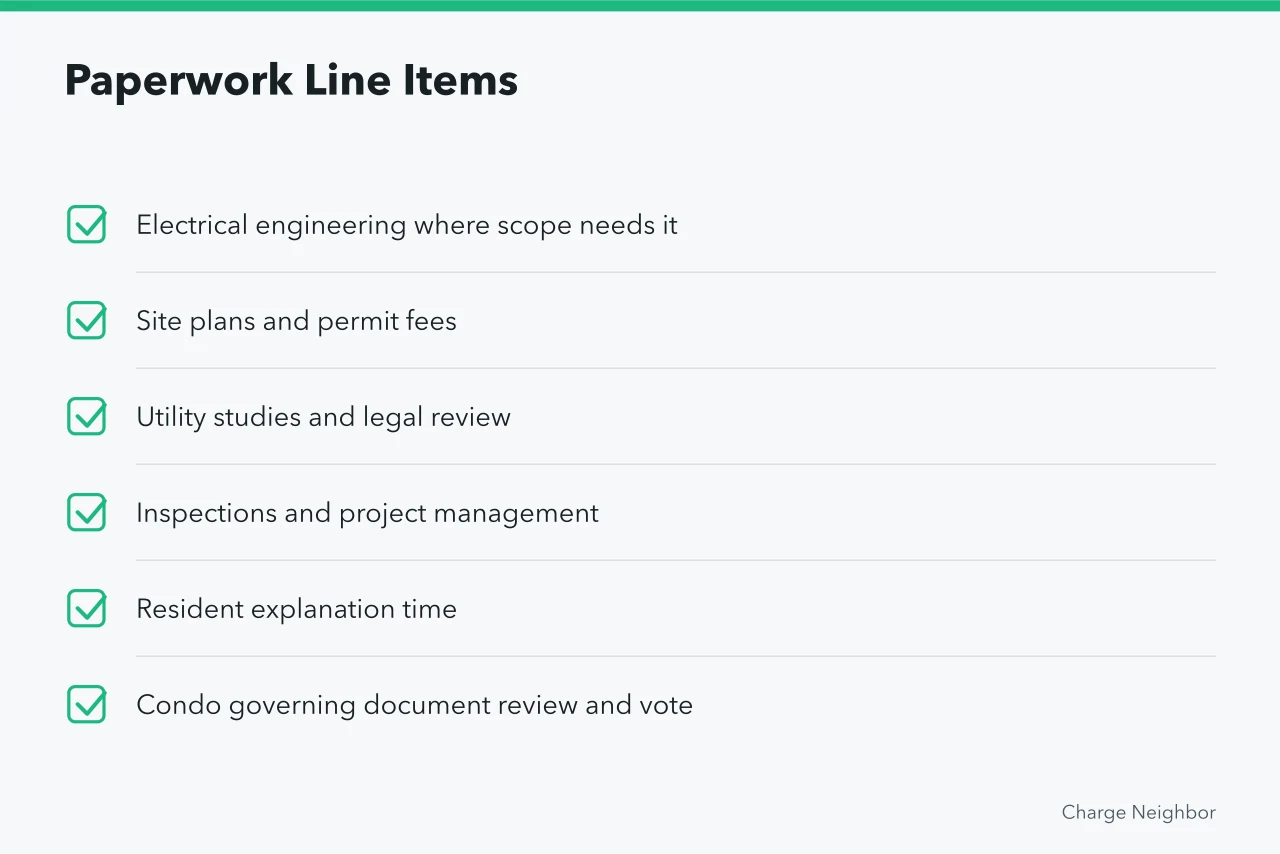

Paperwork Line Items
- Electrical engineering where scope needs it
- Site plans and permit fees
- Utility studies and legal review
- Inspections and project management
- Resident explanation time
- Condo governing document review and vote
Because this is a condominium, governing documents may require review, owners may need to vote, and an agreement must assign ownership, maintenance, and responsibility when equipment breaks. The board completes this work before requesting final prices, reducing the risk of repeating legal review after vendors have already prepared their project scopes.
Contingency is set only after a site assessment. Older buildings may contain undocumented circuits or damaged raceways that stay hidden until a wall is open. Since a reserve chosen before assessment cannot reflect those conditions, the board waits for site evidence before settling that part of the budget.
Step 4: Add the bills that return each year
The board treats operating expense as a separate part of the decision, because construction payment does not settle recurring bills.
A bidder offering hardware alone must still provide an operations figure or identify what the property will purchase separately, so the board can see the continuing cost alongside the installation price.
It records network subscriptions, cellular service, payment processing, support, preventive maintenance and repairs, cleaning, snow clearing, and any insurance change. Each bidder supplies a five-year cost schedule with written assumptions, giving the board a common view of recurring charges rather than a single estimate for the first year.

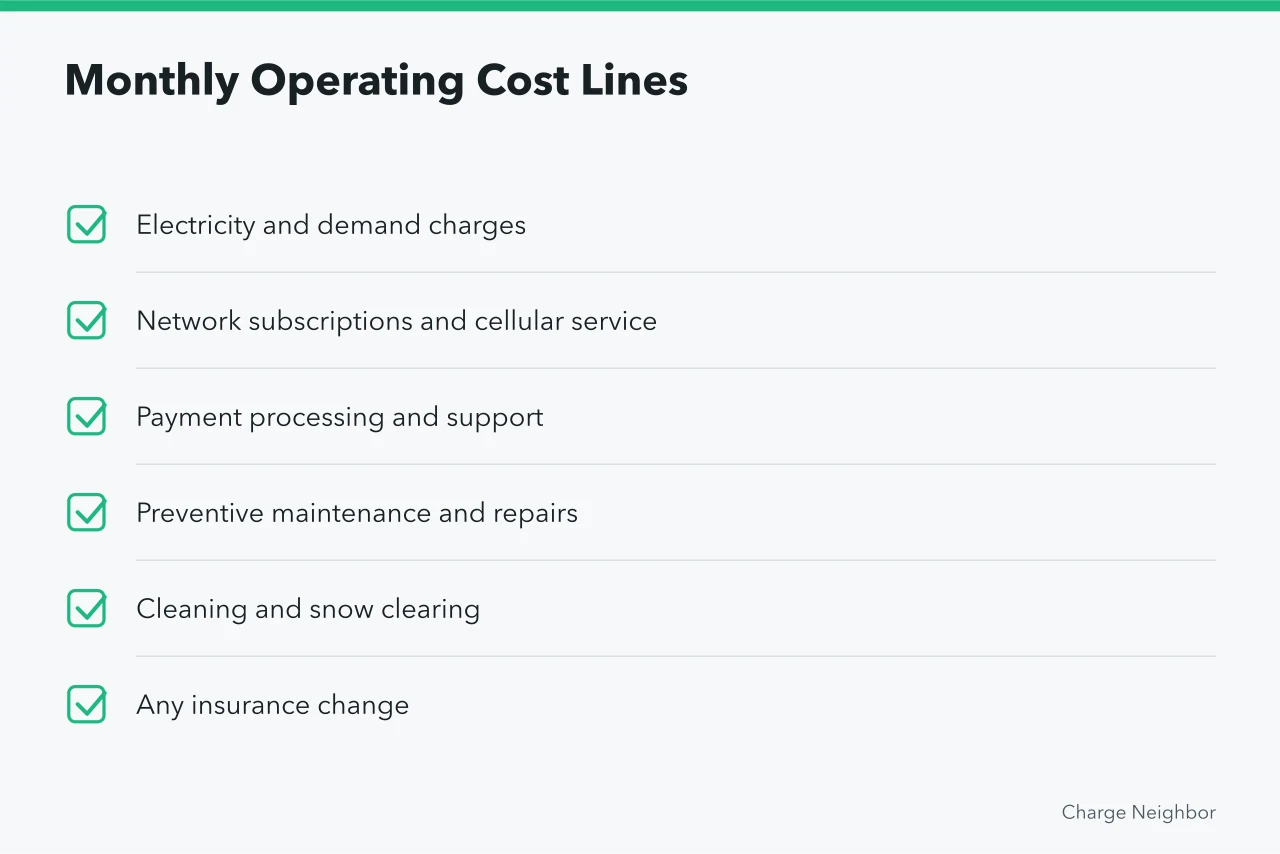

Monthly Operating Cost Lines
- Electricity and demand charges
- Network subscriptions and cellular service
- Payment processing and support
- Preventive maintenance and repairs
- Cleaning and snow clearing
- Any insurance change
Demand charges need particular attention. Some commercial rates bill against the highest fifteen-minute draw, so four cars charging at once can cost more than the energy they consume. The board includes this exposure in its review and asks who pays if user fees do not cover the utility bill and service contract.
That payment responsibility is documented before anyone signs. The board compares the usual budget models and decides how costs are assigned, rather than leaving residents or the association to resolve a shortfall after the first bill arrives.
Step 5: Keep uncertain credits outside the approval figure
Before reducing the approved total for assistance, the board confirms eligibility in writing. At federal level, it checks the Alternative Fuel Vehicle Refueling Property Credit under Section 30C and the Form 8911, which calculates the credit for refueling property placed in service during the tax year.
Eligibility depends on the project's placed-in-service date and ownership type. For business or investment-use property, the credit for all property placed in service at each location is generally the smaller of 30% of its cost or $30,000, according to the business-use credit limit.

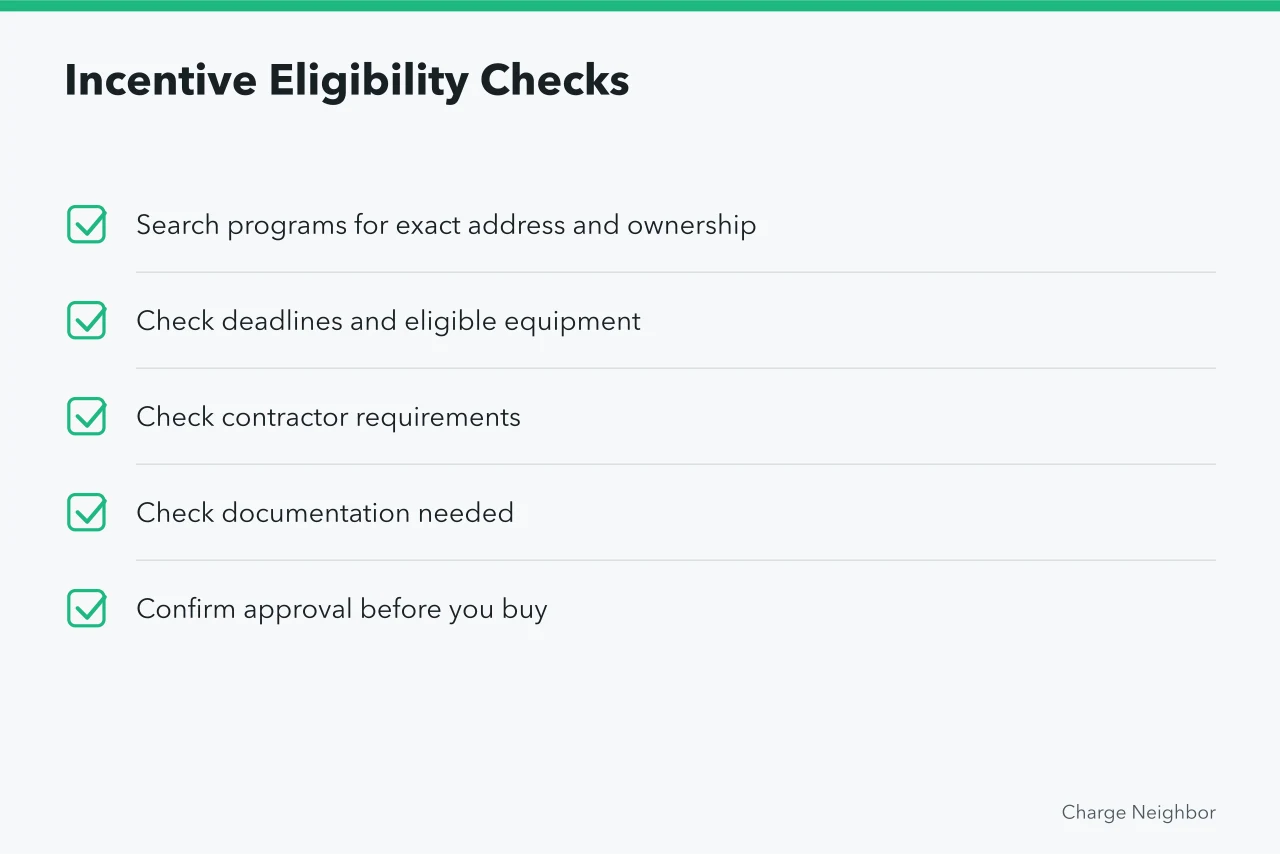

Incentive Eligibility Checks
- Search programs for exact address and ownership
- Check deadlines and eligible equipment
- Check contractor requirements
- Check documentation needed
- Confirm approval before you buy
State, utility, and city programs vary with property location and ownership type. For the building's address, the board checks deadlines, eligible equipment, contractor requirements, documentation, and whether approval must come before purchase. It does not rely on a program detail assumed from another property.
Programs can close, and their terms can change during the year. If the board counts on a credit at the vote but loses it when filing, a funded project can become an assessment. The approved budget therefore remains unreduced until eligibility is confirmed in writing.
Step 6: Define the outcomes to measure
With costs assembled, the board divides total project cost by working ports and EV-ready spaces, then records annual running cost. These measures distinguish an active connection from future readiness that includes unused conduit, while showing the operating bill that returns each year instead of hiding it in a one-time total.
Cost Per Outcome Metrics
Metric
- Total project cost
- Full build and paperwork
- Cost per active port
- Hardware efficiency
- Cost per EV-ready space
- Future expansion value
- Expected annual running cost
- Long-term affordability
What it reveals
- Total project cost
- Cost per active port
- Cost per EV-ready space
- Expected annual running cost
| Metric | Calculation | What it shows |
|---|---|---|
| Cost per active port | Total project cost divided by active ports | What each working port really cost |
| Cost per EV-ready space | Total project cost divided by EV-ready spaces | The price of readiness, including unused conduit |
| Annual running cost | The operations line for one year | The bill that returns every year |
The board considers these measures alongside dedicated or shared access, guaranteed minimum power, billing, data, support, and room to grow. It compares what each design provides, rather than selecting the lowest first phase without accounting for its service and expansion path.
Paying now for conduit, panel space, or managed capacity while installing only the chargers currently needed can avoid replacing a bargain system to add a fifth port. Load management may reduce or eliminate a capacity upgrade, but it can mean less guaranteed power per car at busy times and dependence on software.
Before approval, the board uses questions for multifamily bidders to challenge assumptions and follows a multifamily planning order to settle decisions before pricing. A useful proposal makes its outcome and exclusions clear, rather than relying on its smallest opening number.
Rules carried forward from the decision
The board leaves the comparison with practical rules for other bids: make assumptions visible, check site exposure, include preparation and running costs, and measure a defined outcome. A phone price cannot replace information about the electrical panel, parking layout, and distance needed to build an estimate that holds.
- Do not accept phone-only pricing without the panel, parking layout, and distance between them being seen. Without that information, a bidder is guessing and the estimate will not hold.
- Installing more ports together is usually cheaper because mobilization, trenching, and design are shared. Adding conduit for more ports than the building populates on day one is one reason to plan ahead.
- Residents can often bear the costs, but the approach depends on state law, governing documents, and rate structure. Decide who pays before installation, not after the first bill arrives.
- Trenching and repaving are commonly underestimated, followed by utility work. Both are outside the property's control and have long lead times, so every bidder should state quote assumptions in writing.
- A lower first phase may not mean a lower total. Without an expansion path, a design may need to be torn out to add ports; phased work can also bring a crew back a second or third time. Price the next phase before approving the first.
