carsharing, electric car, automobile, smart, small car, nuremberg, charging station, charge, electric car, electric car, electric car, electric car, electric car. Apartment EV charging stages: when to commit, when to stop
Photo by andreas160578 on Pixabay

Guides

Part of Apartment EV charging: cost guide for 2027

Apartment EV charging stages: when to commit, when to stop

Apartment EV charging stages from assessment to closeout: where commitments run ahead of cash, the four late surprises, and the last point to stop cheaply.

What to take away

  • Track the budget by when cash leaves, not by construction phase. The two timelines differ.
  • Most of the money is committed long before most of it is spent, so exposure peaks early.
  • Four moments cause nearly every late cost changeopening the panel, trenching, plan check, and the utility response.
  • Hold retention until commissioning passes and the closeout pack is delivered, not until the crew leaves.
  • Spend on facts before hardware. Assessment-stage dollars cut uncertainty in a number ten times larger.

An apartment EV charging project moves through six stages: assessment, design and permitting, funding applications, order and deposit, construction, and commissioning and closeout. A construction schedule tells you when work happens. It does not tell you when you are exposed, and for a board approving a budget that is the more useful question.

Commitments run well ahead of payments in apartment charging. By the time significant cash has left, the decisions that set the total were made months earlier.

The cash timeline

Assessment. Small amounts: the electrical survey, possibly a professional engineer. A few thousand at most, and the highest-value money in the project. It is also the only stage where walking away costs almost nothing.

Cash timeline and reversibility

  1. Assessment
    survey, engineer, few thousand, walk away cheap
  2. Design and permitting
    drawings, fees, utility study, reversible
  3. Funding applications
    no cash out, conditions attach
  4. Order and deposit
    first large commitment, non-refundable
  5. Construction
    progress payments, scope fixed, bulk of cash
  6. Commissioning and closeout
    final payment and retention

Design and permitting. Drawings, permit fees, sometimes a utility study. Still modest, still largely reversible.

Funding applications. No cash out, but this is where conditions attach. A program that requires approval before construction has just constrained your schedule.

Order and deposit. The first large commitment. Equipment lead times push ordering ahead of construction, and a deposit on switchgear or chargers is generally not refundable.

Construction. Progress payments against milestones. The bulk of the cash, and by now the scope is fixed.

Commissioning and closeout. Final payment and retention. The last hold you have on the contractor.

Your bargaining power is greatest at assessment, when almost nothing has been spent. It is gone by construction, when almost everything has.

Read the six stages as decision points:

StageCommit whenStop or pause when
AssessmentThe board wants facts about capacityNever too late: walking away is nearly free
Design and permittingThe assessment shows a workable route and capacityThe design depends on capacity the survey did not confirm
Funding applicationsA program fits and its conditions suit the schedulePre-approval is required and the schedule cannot wait
Order and depositPlan check has passedPlan check is open: this is the last point to stop cheaply
ConstructionThe scope is fixed and the permit is issuedA late surprise needs a change order the board has not approved
Commissioning and closeoutCommissioning passes and the closeout pack is deliveredItems fail commissioning: hold retention

Four moments where costs change late

When the panel is opened. Undocumented circuits, damaged raceways, less spare capacity than the schedule claimed. Older buildings hold surprises and this is where they surface, which is why an honest capacity assessment is the first thing to ask a contractor for.

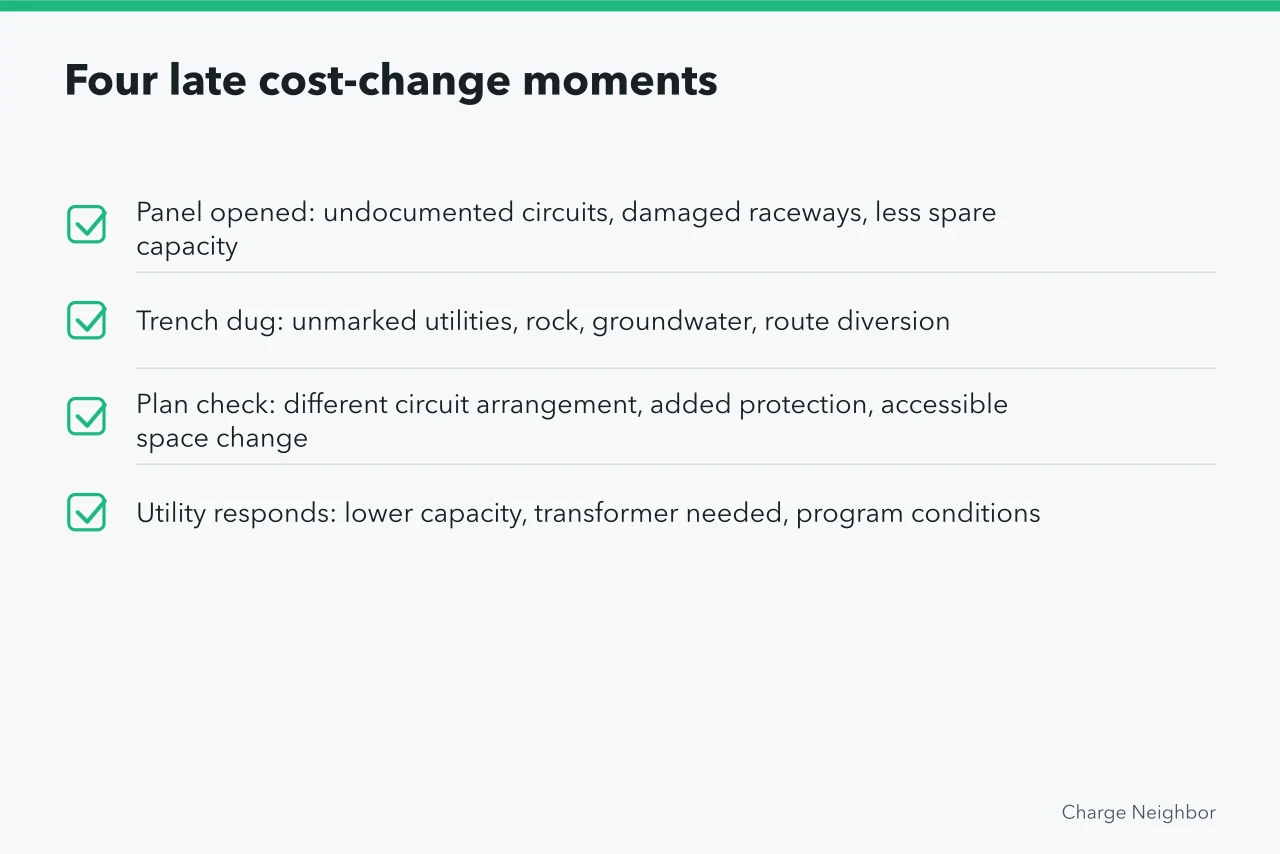

Four late cost-change moments

  • Panel openedundocumented circuits, damaged raceways, less spare capacity
  • Trench dugunmarked utilities, rock, groundwater, route diversion
  • Plan checkdifferent circuit arrangement, added protection, accessible space change
  • Utility respondslower capacity, transformer needed, program conditions

When the trench is dug. Unmarked utilities, rock, groundwater, or a route that has to divert. Trenching is the most common source of change orders in this work.

At plan check. A reviewer asks for something the design did not include: a different circuit arrangement, additional protection, a change to an accessible space. Cheap on paper, expensive if equipment is already ordered, which is the argument for treating plan check as a gate nothing gets ordered before.

When the utility responds. Capacity is lower than assumed, a transformer is needed, or the program has conditions. This sits outside everyone's control and carries the longest lead time.

Budget contingency against these four by name rather than adding a general percentage. It makes the number defensible to a board and shows what the contingency is for.

Sequence the money against the readiness

The general readiness sequence for a property preparing to add charging is covered in the Alternative Fuels Data Center's material on electric vehicle readiness. The budgeting point that follows is simple: spend on facts before spending on hardware.

Every dollar at assessment stage reduces uncertainty in a number ten times larger. Every dollar spent on equipment before the assessment is a bet.

Watch the funding calendar, not just the build calendar

Funding programs run on their own timetable, and it rarely matches yours.

Funding calendar vs build calendar

Funding calendar

Pre-approval
Required before work
Allocations
Exhausted mid-year
Documentation
Collect during construction
Tax year
Placed-in-service date
Conflict
Usually wins

Build calendar

Pre-approval
Cannot start when you like
Allocations
Fixed construction date
Documentation
Reconstruct afterward
Tax year
Construction schedule
Conflict
Can move

State programs vary widely in how these conditions are structured. The state-by-state records, such as the index of electricity laws and incentives in New York, show the level of detail worth checking for your own state before you set a construction date. In New York, for example, NYSERDA's Charge Ready NY 2.0 offers rebates to public, private and not-for-profit organizations that install Level 2 EV charging stations at workplaces, multi-unit dwellings or hotels and motels; its eligible-equipment list and application rules are exactly the conditions to read before ordering.

The federal side has closed for new projects. The section 30C alternative fuel vehicle refueling property credit cannot be claimed for property placed in service after June 30, 2026, so a placed-in-service date after that no longer carries it.

Map the funding deadlines onto the construction schedule on one page. Where they conflict, the funding calendar usually wins, because construction can move and an allocation cannot.

Hold retention properly

The final payment is the only hold you have left, and boards give it up too early.

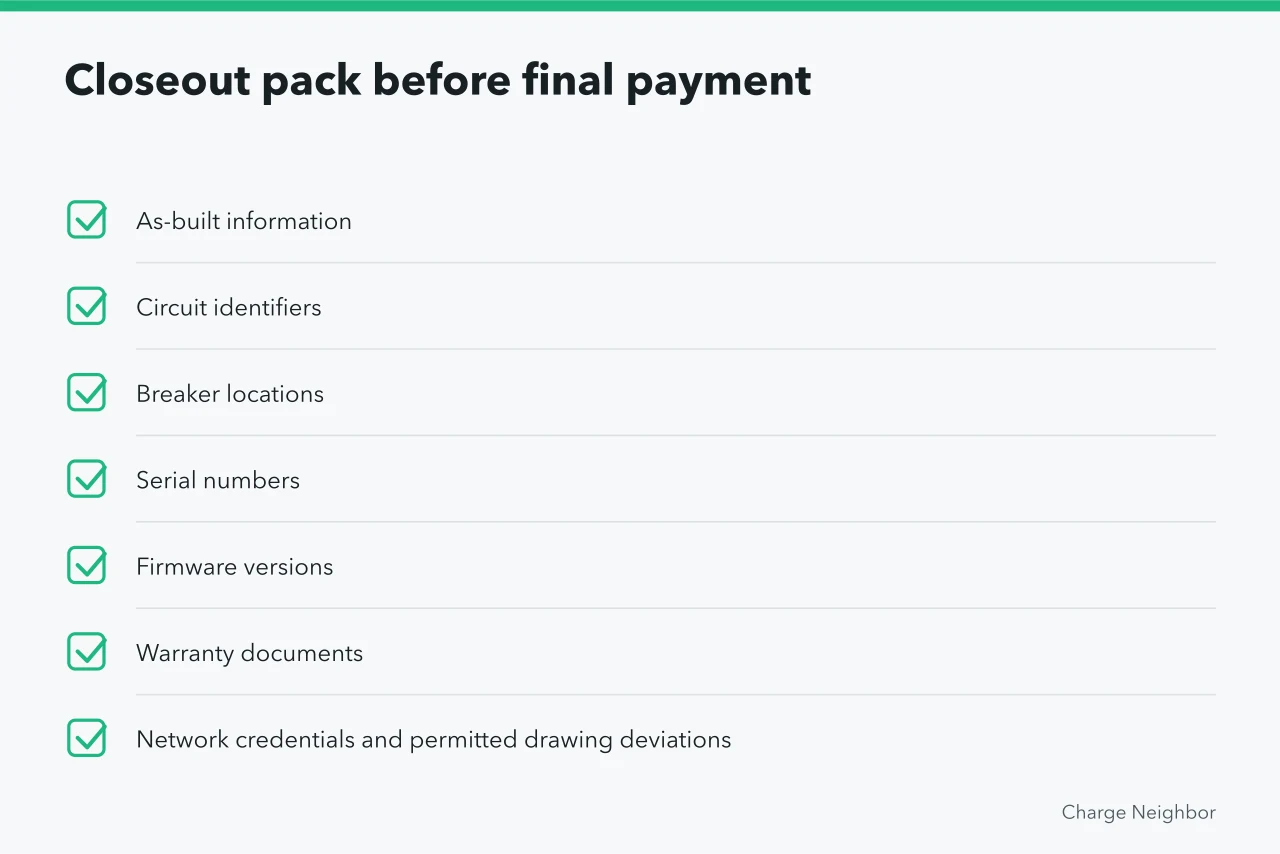

Closeout pack before final payment

  • As-built information
  • Circuit identifiers
  • Breaker locations
  • Serial numbers
  • Firmware versions
  • Warranty documents
  • Network credentials and permitted drawing deviations

Release it when commissioning passes and the closeout pack is delivered:

  • circuit identifiers
  • breaker locations
  • serial numbers
  • firmware versions
  • warranty documents
  • network credentials
  • any deviation from the permitted drawing That pack gets assembled while the installer is still on site, not afterwards.

Paying in full when the crew drives away means chasing that pack by email for three months.

A worked example of the tracker

Keep one sheet with four columns. Update it at each stage, because the gap between the first two columns is your exposure.

StageCommittedSpentRemainingWhat would change it
AssessmentSurvey and engineer feesSame dayFull budgetNothing. Walking away is nearly free
Design and permittingDrawings, permit feesMost of itFull budgetReviewer comments
Order and depositEquipment, non-refundableDeposit onlyFull budgetLead times, price at order
ConstructionFull scopeProgress paymentsContingencyPanel, trench, plan check
CommissioningFull scope plus retentionAll but retentionRetentionFailed commissioning items

Boards get surprised because they track spending only. Tracking commitment shows the exposure while there is still time to act on it.

Where the money comes from is covered in the cost guide, and stress-testing the numbers before approval is what turns this timeline into a defensible decision.

Common questions

When is the last point we can stop cheaply?

Before the equipment deposit. Up to that point most of the spend is surveys, drawings and fees, and the scope is still open. After the deposit you are committed to most of the work.

How much contingency is realistic?

Enough to cover the four late-change moments that apply to your building. Ask the contractor which of them are likely here and price those, rather than picking a percentage out of the air. A number tied to named risks survives a board meeting.

Can we order equipment early to beat lead times?

Only after plan check. Ordering before review is how boards end up owning equipment they cannot install. Switchgear and chargers are not returnable in most cases, so the deposit is the point of no return.

Who tracks the funding deadlines?

Name one person. Missed conditions are almost always administrative rather than technical, and they can cost the whole allocation. Put the pre-approval date, the allocation deadline and the placed-in-service date on the same one-page schedule as construction.
