Condo EV charging planning: rights, rules and approvals

Condo EV charging planning for boards: classify the parking, check your state's right-to-charge law, adopt a policy, and decide who owns the equipment.

What to take away

  • Classify every parking space before anything else. Who may approve work depends entirely on how the space is held.
  • Several states limit what a board may refuse at an owner's assigned space. Find out where yours stands before you write a policy.
  • Adopt the policy before the first request arrives. Writing rules for a specific owner is how boards end up in disputes.
  • Decide who owns the equipment. That single answer determines maintenance, insurance and what happens when a unit sells.

Condo EV charging planning is not really an electrical project. It becomes one eventually, but it starts as a property rights question, and boards that skip that part end up rewriting their decision twice.

In a house, the person who wants the charger owns the parking, the panel and the wall. In a condominium those three things can belong to three different parties, and the board sits in the middle of all of them.

Classify the parking first

Every space involved needs a label, because the label decides who approves the work.

A space might be part of a unit, assigned for exclusive use, leased, licensed, or plain common property. An owner with a deeded space has different standing from one with a revocable license, and the association's control over each differs accordingly.

Draw a parking plan showing space numbers, walls, columns, accessible spaces, electrical rooms, meters, fire lanes and plausible conduit routes. Alongside it, collect who charges today, which spaces are workable and what power sits near them.

Then resist the obvious assumption: that an owner may run a circuit from the nearest panel to their own space. Almost every part of that route is common property, and using it is a decision the board has to make deliberately rather than by default.

Find out what your state actually says

This is the step boards most often skip, and it is the one that can invalidate a policy after it is adopted.

Several states have passed "right to charge" provisions. California's is Civil Code Section 4745, which bars a common interest development from prohibiting an owner's charging station at a parking space the owner is entitled to use, while allowing the association to set reasonable conditions. The pattern runs the same way elsewhere: typically, an association cannot flatly ban an owner from installing a charger in their own assigned space.

It may set reasonable conditions: a licensed contractor, architectural standards, insurance, paying for electricity, and responsibility for maintenance and removal.

Three more states show what those conditions look like in statute:

  • Illinois(765 Illinois Compiled Statutes 1085/30, enacted June 9, 2023). The U.S. Department of Energy's Alternative Fuels Data Center summary of Illinois EV charger policies for condominiums says associations may not prohibit or restrict the installation or use of an EV charger in a unit owner's designated parking space. Associations may impose reasonable restrictions, but those may not increase the cost of the charger or decrease its performance. The owner must comply with health and safety codes and architectural standards, engage a licensed installation contractor, and provide a certificate of insurance within 14 days of installation and annually. The owner pays for the electricity and for installation, operation, maintenance, repair, removal or replacement.
  • Virginia(Code § 55.1-1962.1). Except where the condominium instruments provide otherwise, no unit owners' association shall prohibit a unit owner from installing a charging station for personal use within the unit or a limited common element parking space appurtenant to it. The association may prohibit an installation that is not technically feasible or reasonably practicable due to safety risks, structural issues or engineering conditions.
  • Washington(Washington Uniform Common Interest Ownership Act). As summarized in a Washington House bill report, an association may not adopt or enforce any rule that effectively prohibits or unreasonably restricts the installation or use of a charging station within a unit or in a designated parking space, though it may impose reasonable restrictions.

The Alternative Fuels Data Center lists laws like these state by state, so check your own state's entries there before the board writes a policy.

It is a starting point, not legal advice. Your association's attorney reads the current statute against your actual governing documents, because the two can conflict and the resolution is not always obvious.

Write the policy before the first request

A board that writes rules in response to one owner's application will be accused of writing rules about that owner. Adopt the policy while nothing is pending.

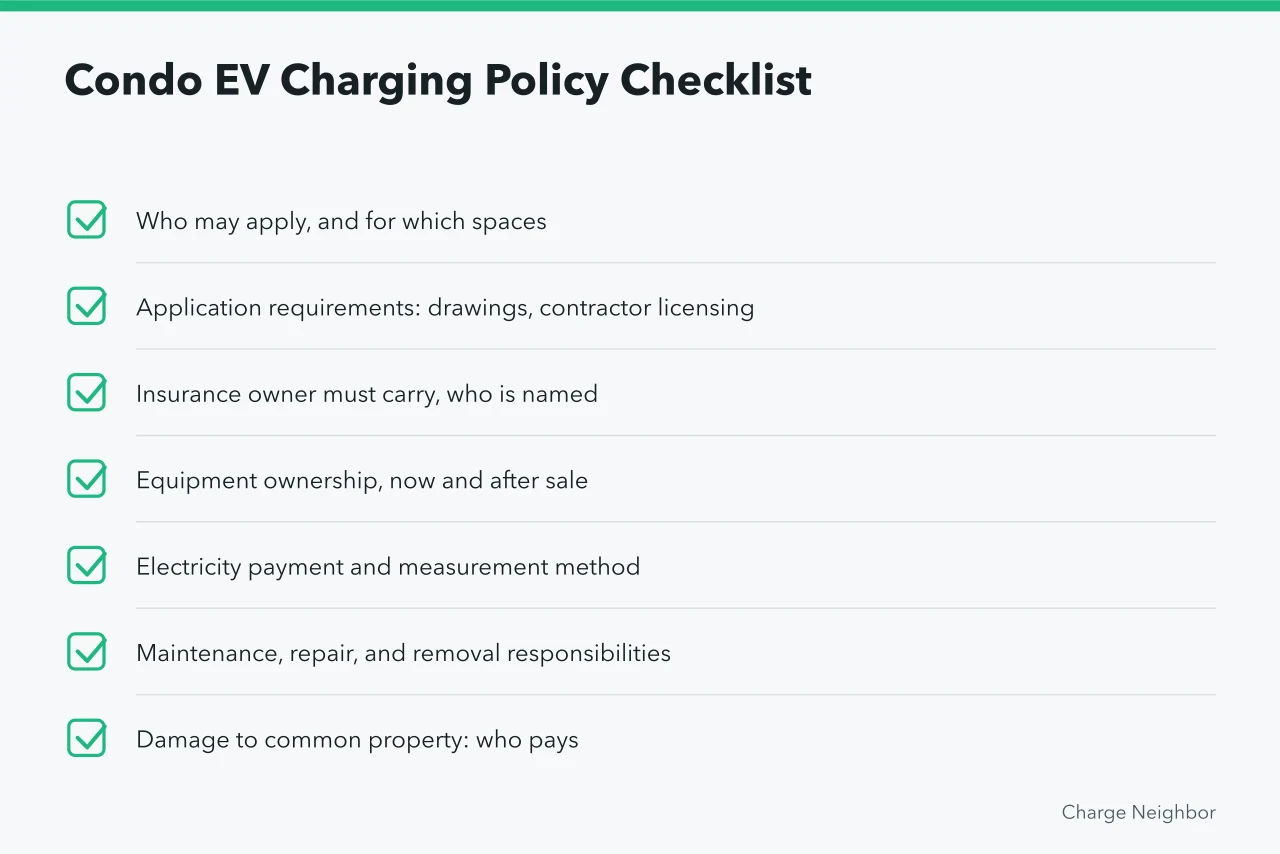

Condo EV Charging Policy Checklist

  • Who may apply, and for which spaces
  • Application requirementsdrawings, contractor licensing
  • Insurance owner must carry, who is named
  • Equipment ownership, now and after sale
  • Electricity payment and measurement method
  • Maintenance, repair, and removal responsibilities
  • Damage to common propertywho pays
  • Capacity exhaustionhow board handles

The rule for what happens when the panel fills up is worth real thought. Early applicants get straightforward approvals. At some point there is no capacity left, and the board needs a rule decided in advance rather than a queue argued in a meeting.

Decide the ownership model

Three models cover most condominiums, and they behave very differently over time.

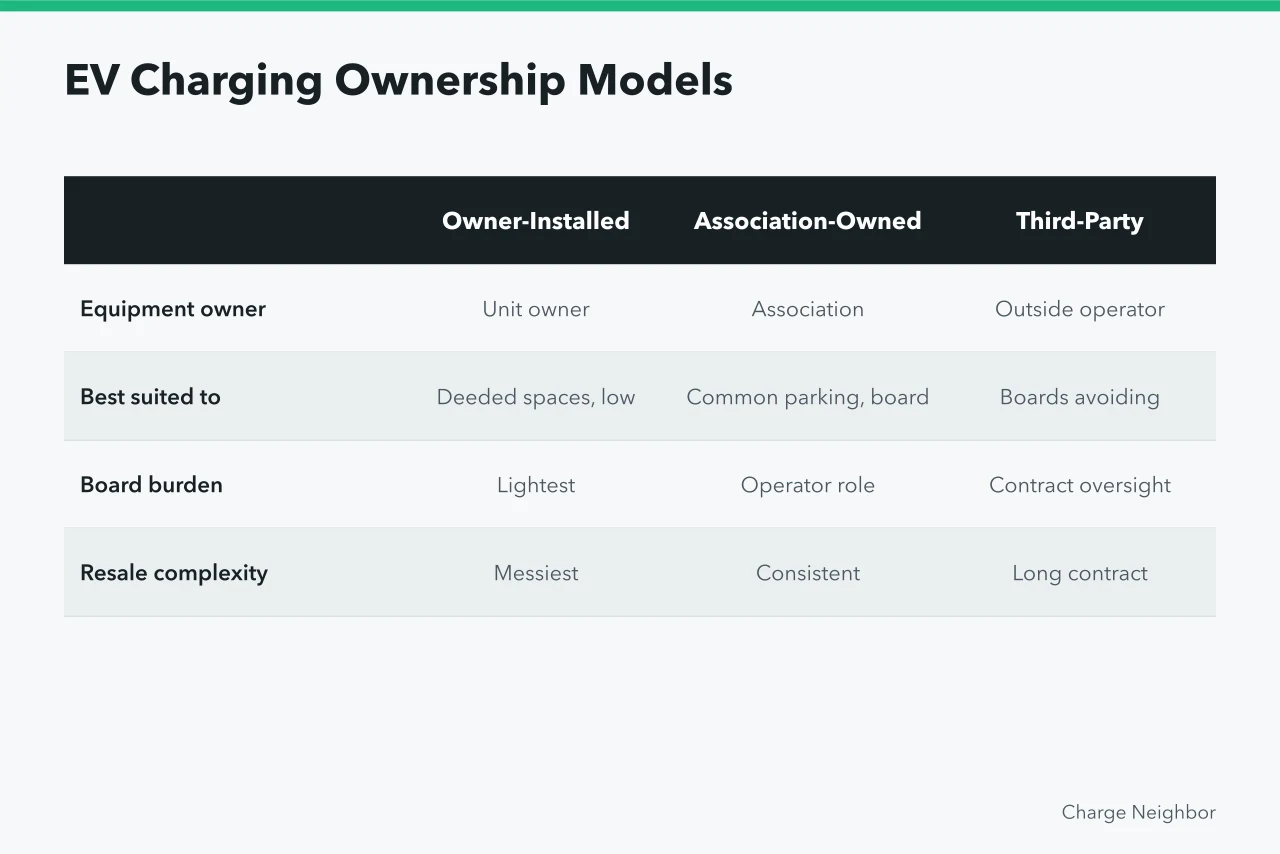

EV Charging Ownership Models

Owner-Installed

Equipment owner
Unit owner
Best suited to
Deeded spaces, low demand
Board burden
Lightest
Resale complexity
Messiest

Association-Owned

Equipment owner
Association
Best suited to
Common parking, board control
Board burden
Operator role
Resale complexity
Consistent

Third-Party

Equipment owner
Outside operator
Best suited to
Boards avoiding capital cost
Board burden
Contract oversight
Resale complexity
Long contract

Who owns the equipment

Owner-installed at an assigned space
The unit owner
Association-owned shared ports
The association
Third-party owned and operated
An outside operator

Best suited to

Owner-installed at an assigned space
Buildings with deeded or exclusive-use spaces and low early demand
Association-owned shared ports
Common parking, or where the board wants control of standards
Third-party owned and operated
Boards unwilling to run a service or carry the capital cost

Owner-installed is the lightest for the board and the messiest at resale, because equipment attached to common property has to have its status written down. Association-owned gives consistency and a maintenance budget line, but the association becomes an operator with residents as customers. Third-party removes the capital cost and adds a long contract that somebody must read closely.

Get an electrical assessment for the whole building

Not for one space. The panel that serves the first applicant will also serve the tenth. Approving requests one at a time without a capacity plan is how a board ends up telling owner eleven that the answer is now no.

Ask the engineer for spare capacity in amps, feasible routes to each parking area, metering options, and what load management would allow. The contractor who would do the work belongs in that talk, because routing through the building often costs more than capacity.

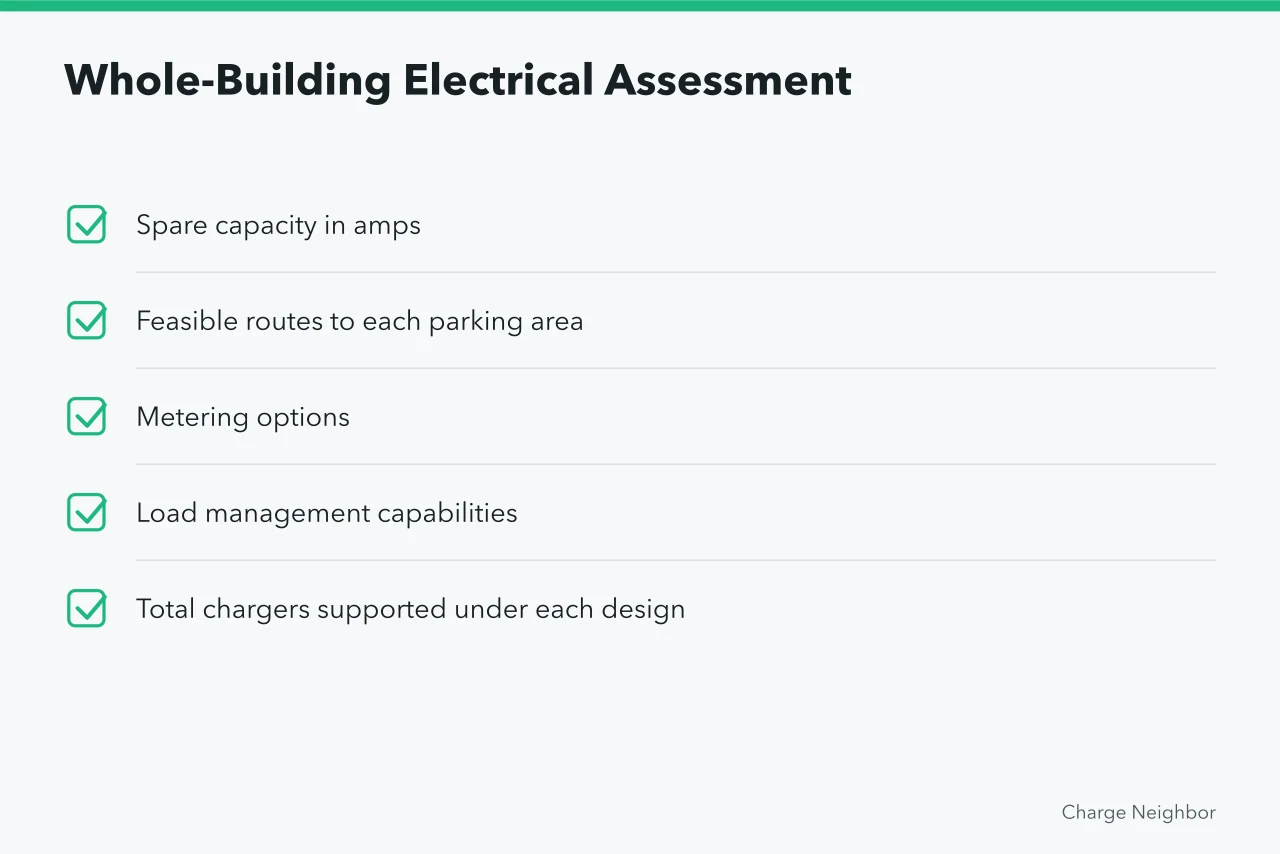

Whole-Building Electrical Assessment

  • Spare capacity in amps
  • Feasible routes to each parking area
  • Metering options
  • Load management capabilities
  • Total chargers supported under each design

Check codes and the approvals you will need

Local building codes, parking ordinances and zoning rules all bear on where equipment can go and what has to be shown on a drawing. The Alternative Fuels Data Center, run by the U.S. Department of Energy, publishes an overview of building codes, parking and zoning ordinances for charging, covering the categories to ask your building department about.

California shows what a streamlined permit path looks like. According to Stanford's Institute for Economic Policy Research, AB 1236 (Chiu, 2015) and AB 970 (McCarty, 2021) established standard requirements for all cities and counties for EV charging station permits, and AB 1236 made those permits administrative and non-discretionary, limiting review to health and safety. In Los Angeles County, for example, a permit is required to install an EV charger, LA County Public Works Building and Safety issues it, and the application goes through EPIC-LA, the county's online system for managing permits and inspections. The local office tells you whether the project also needs a plan check.

Also confirm what your own documents require. Many associations need architectural committee review for anything attached to a common element, and some require an owner vote for work of a certain scale. Finding that out after approval is expensive.

Handle the money explicitly

Decide how electricity is measured and billed, and write it down. Submeter, session data from a networked charger such as ChargePoint, a flat monthly fee, or a share of a common meter each have tradeoffs, and each needs a rule for what happens when the utility rate changes.

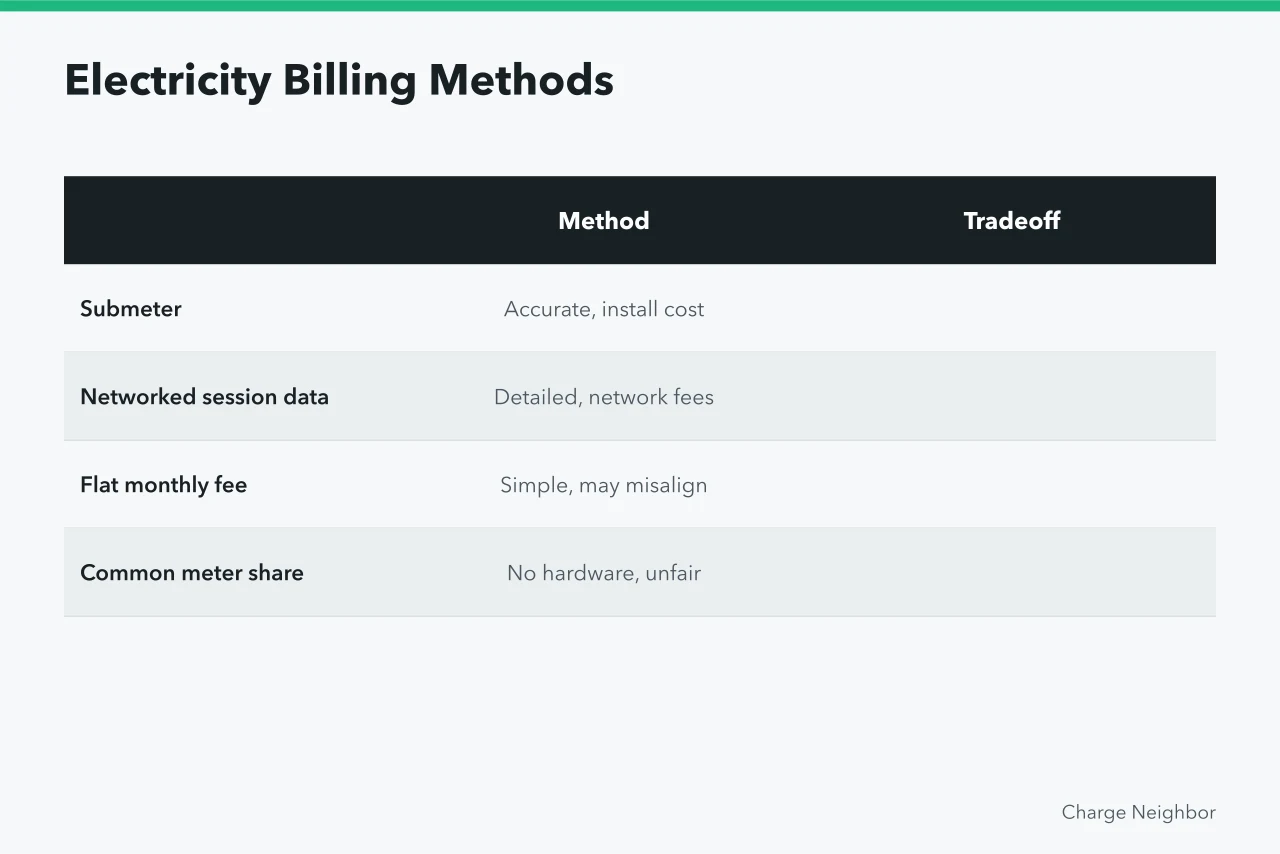

Electricity Billing Methods

Method

Submeter
Accurate, install cost
Networked session data
Detailed, network fees
Flat monthly fee
Simple, may misalign
Common meter share
No hardware, unfair

Tradeoff

Submeter
Networked session data
Flat monthly fee
Common meter share

Decide who pays for shared infrastructure. If the association runs conduit and panel capacity ten future owners will use, the board should set that cost allocation once and record it. Don't argue it each time someone connects.

Then price the project before the vote, and make every bid cover the same scope: equipment, conduit and wiring, any panel or service upgrade, permits and inspection, metering, and the maintenance and removal obligations the board is accepting. Broken out that way, the offers can be compared line by line instead of as one blended figure.

Ask whether any outside money applies, and check the dates. The federal Alternative Fuel Vehicle Refueling Property Credit (section 30C) has a cutoff date: the IRS instructions for Form 8911 state that the credit cannot be claimed for property placed in service after June 30, 2026. Check that date with your accountant before the credit goes into a funding plan. The Alternative Fuels Data Center tracks the state and utility programs that still help pay for charging infrastructure.

The funding models differ mostly in who profits and who carries the risk, which is the comparison worth having before the vote.

Approve, install, then keep the file

When the board approves, it should approve a specific drawing, a specific contractor, and a specific set of conditions, all in the minutes.

Keep the application, drawings, permit, inspection sign-off, insurance certificate, warranty and the signed agreement together. When a unit sells or the board turns over, that file is the only thing that establishes what was agreed.

From there, what tends to go wrong and what it costs is worth reading before you approve the first application, and the maintenance obligations you are creating should be understood before you decide who owns the equipment.

Common questions

Can our board just say no?
In some states, not to an owner's own assigned space, though you can impose reasonable conditions. In others you have more discretion. Ask your attorney rather than assuming either way.
Who pays if the installation damages common property?
The owner, if your policy says so and their insurance covers it. That is exactly why the insurance requirement belongs in the policy rather than in a later argument.
What happens when the owner sells?
Whatever your agreement says. Without one, you have equipment of uncertain ownership attached to common property, which is a problem for the buyer, the seller and the board at once.
Do we have to treat every applicant the same?
You have to apply your policy consistently. That is the argument for adopting it before requests arrive rather than after.
